EPATRONIC
Available · Industry solution for construction companies and trades

From bill of quantities to final invoice – your construction site in the cloud

The industry solution built on EUTHENIA ERP: bills of quantities (LV) from GAEB, quantity take-off, invoicing according to VOB (German construction contract rules) with XRechnung, site diary and defects in one platform – in the office and, with the site app, even without a network connection.

One project
Estimating, execution and invoicing on the same data
Mobile
Site diary, photos and defects right on site
GAEB & VOB
Bills of quantities, take-off and invoicing
EUTHENIA ERP
Purchasing, inventory, HR and e-invoicing included

Video

EUTHENIA Construction in under two minutes

Construction schedule, bill of quantities and change orders, measurement and progress invoice, site diary, defects, subcontractor awarding and cost control – shown with a sample project and invented data.

1:47 minutes · English voice-over · sample project with invented data

Features

Everything a construction project needs

From estimating and site management to invoicing and post-calculation – in the office and on site.

Projects & construction schedule

Building projects with sections, trades, dates and milestones – with a construction schedule and dependencies.

BoQ, estimating & change orders

Import bills of quantities (LV) from GAEB, calculate unit prices and submit them as a bid (X84); change orders and quantity changes according to VOB/B.

Take-off & invoicing

Record quantities per BoQ item or import them as GAEB X31, create progress and final invoices according to VOB with retention and cash discount – as PDF and XRechnung.

Site diary

Record weather, staff, equipment, work performed, deliveries and obstructions with photos on your smartphone – even without a network connection; daily report as PDF.

Defect management

Pin defects directly on the floor plan, with photo, deadline and trade – in the site app and in the office. Subcontractors mark them as resolved through their own access.

Equipment & staff

Schedule crews, machines and vehicles across all sites and record hours precisely per project.

Post-calculation

Continuously compare planned and actual costs per cost type: labour, material, equipment and subcontractors.

Subcontractors & awarding

Requests as GAEB X83, bids as X84, bid comparison and awarding; contract in purchasing, invoices with construction withholding tax (Bauabzugsteuer) and commitments in the post-calculation.

Subcontractors

From request to invoice

One continuous workflow – from the bill of quantities and awarding to the costs in your project.

1

Request

Bundle BoQ items into a package and send it to subcontractors as GAEB X83.

2

Compare

Import bids as X84 or enter them manually; the bid comparison shows the ranking, unusual prices and your own estimate.

3

Award

Award with a single click – the subcontractor contract is created in purchasing and the tax exemption certificate (Freistellungsbescheinigung) is checked.

4

Invoice

Book the subcontractor's invoices: construction withholding tax is calculated, the costs appear in the post-calculation and the commitments in the forecast.

A look inside

How you work with EUTHENIA Construction

All images are screenshots of the application – one sample project, all the way from the bill of quantities to the progress invoice.

euthenia.cloud/construction · InvoicingLive application

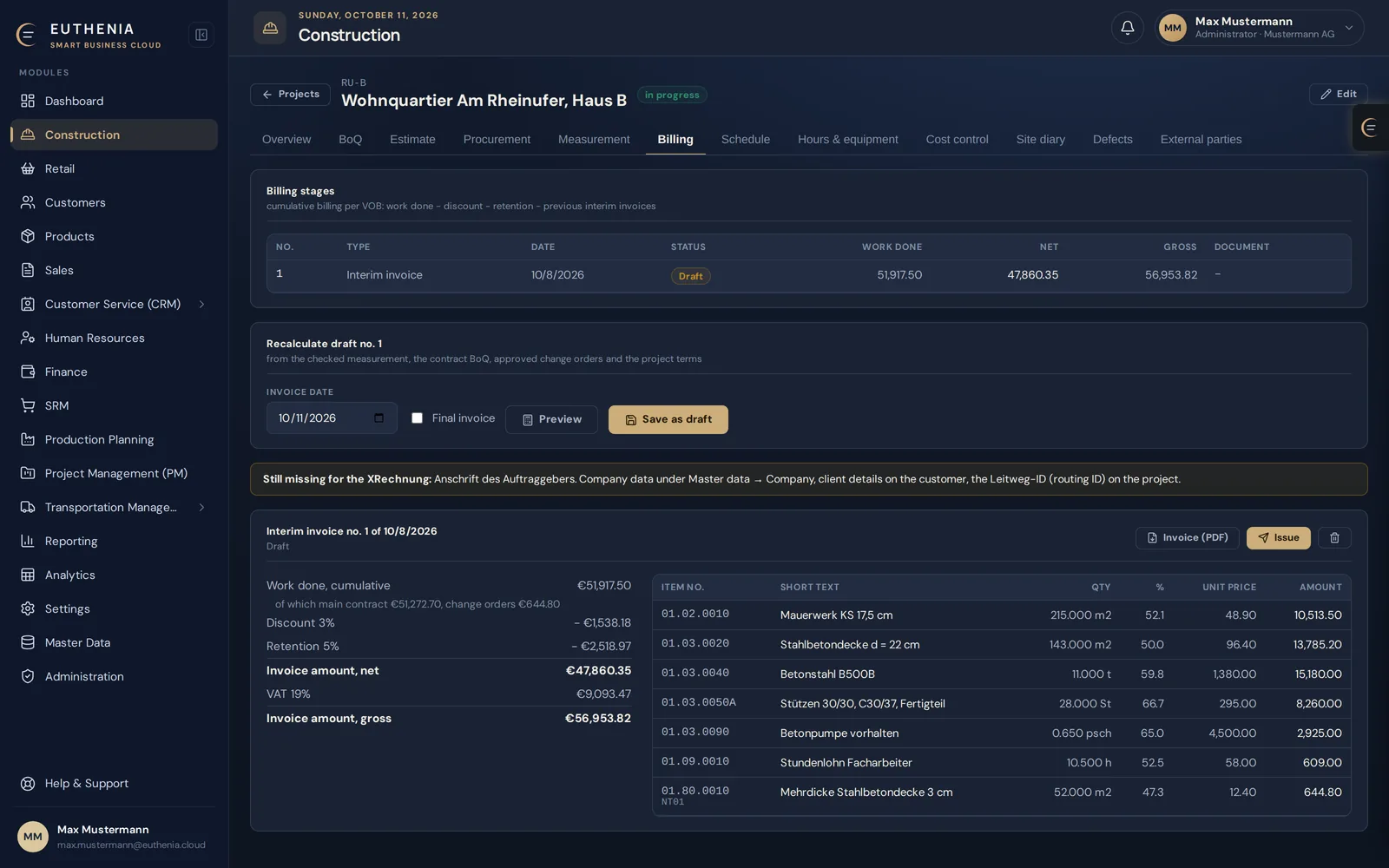

Progress invoice according to VOB from the verified take-off: work performed, discount, security retention and approved change order

Progress invoice according to VOB from the verified take-off: discount, security retention and the approved change order NT01 are included automatically

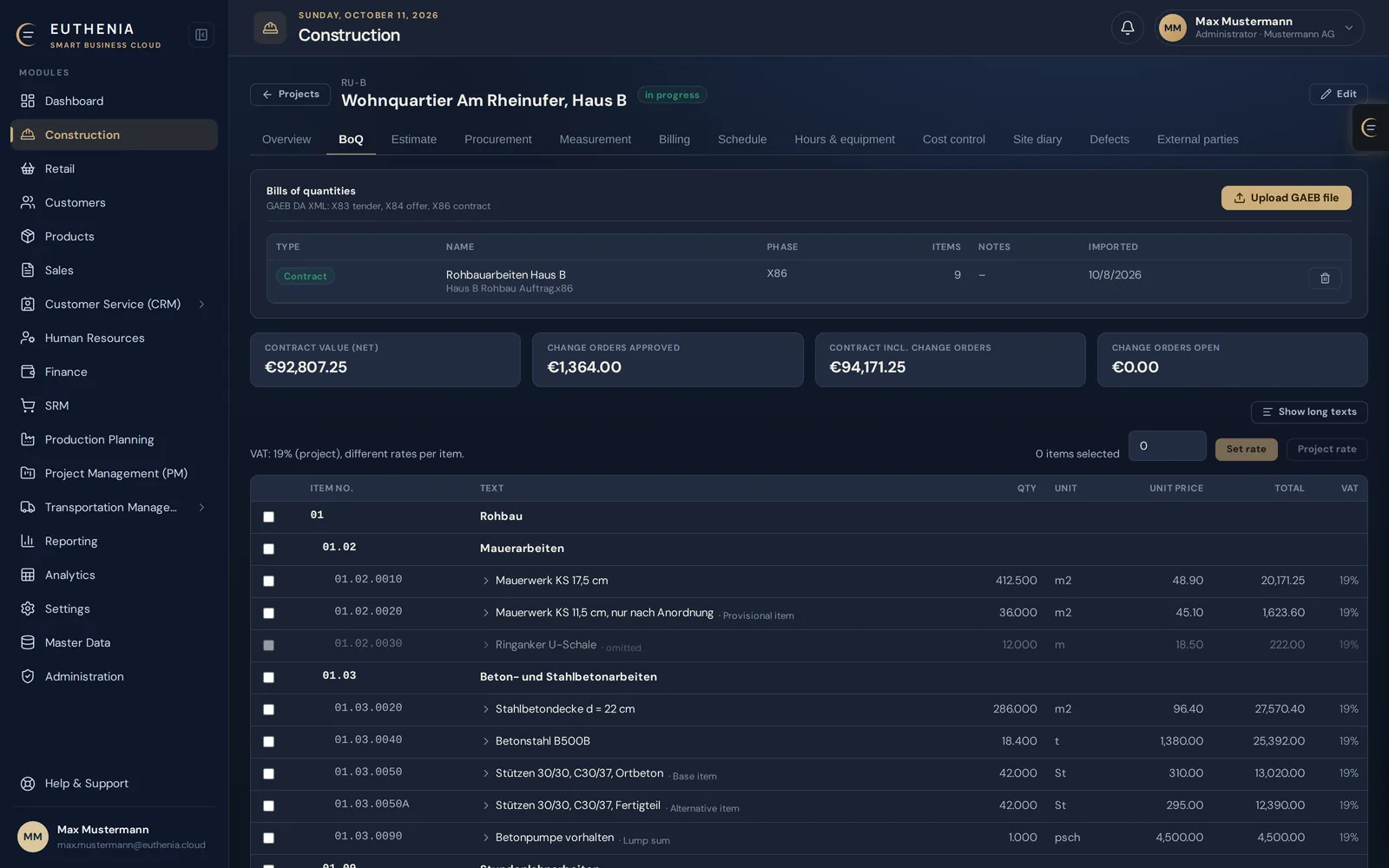

Bill of quantitiesLive application
Bill of quantities from GAEB X86 with contract value, approved change orders, contingency and alternative items

Bill of quantities from GAEB X86: contract value, change orders, contingency, alternative and omitted items

Site diaryLive application
Site diary in the office: days from the construction site with staff, weather and a reported obstruction

Site diary in the office: everything recorded on site, including obstructions under VOB/B § 6

Planning

Your construction schedule at a glance

Trades, durations and dependencies in one view. If the shell construction is delayed, the follow-on trades move automatically – status, progress and the agreed completion date always stay in view.

  • Critical path, milestones and acceptance
  • Baseline and planned-vs-actual comparison on the reporting date
Construction schedule · Haus BLive application

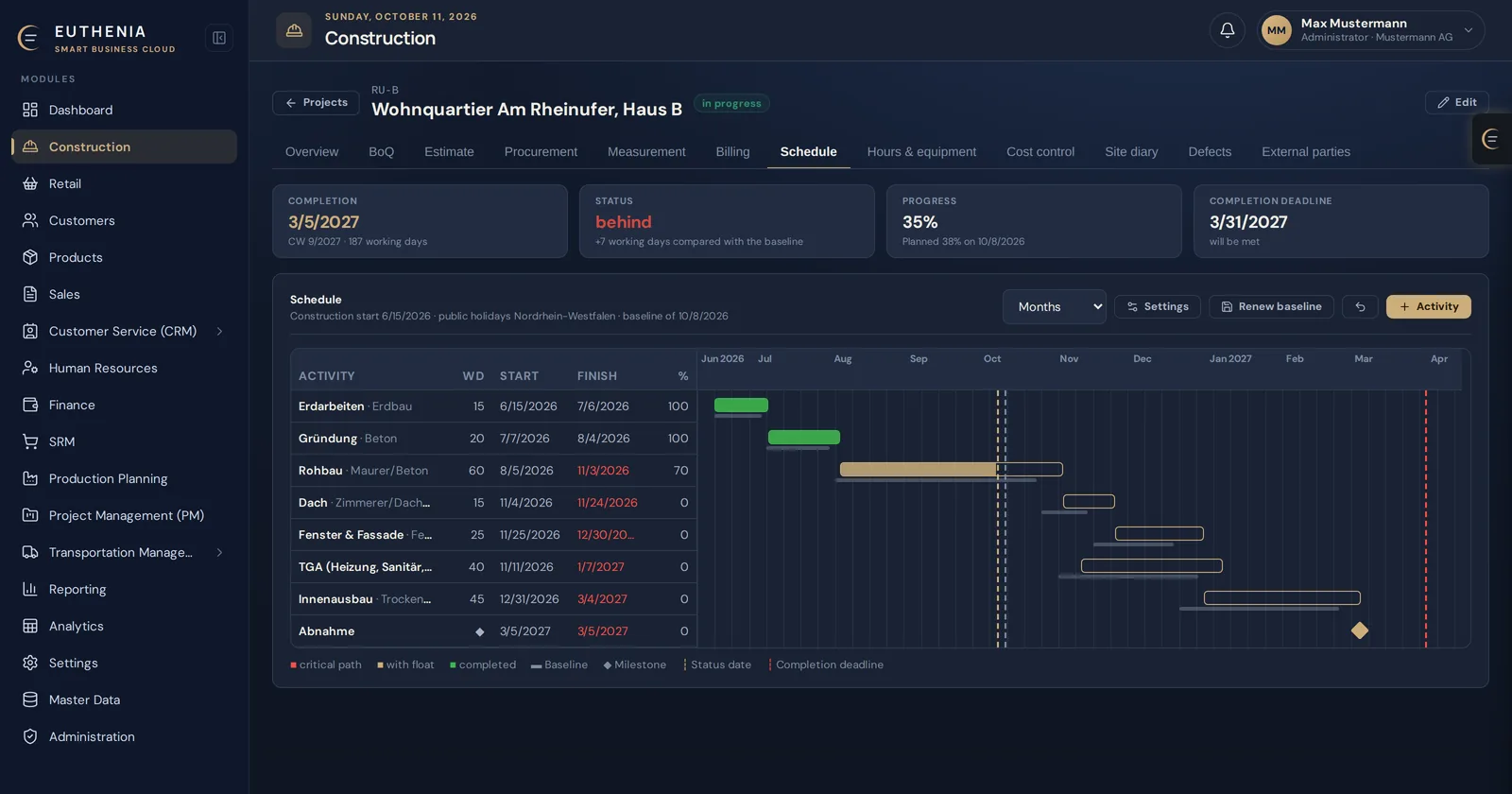

Construction schedule in monthly view with baseline, reporting date, progress and completion date

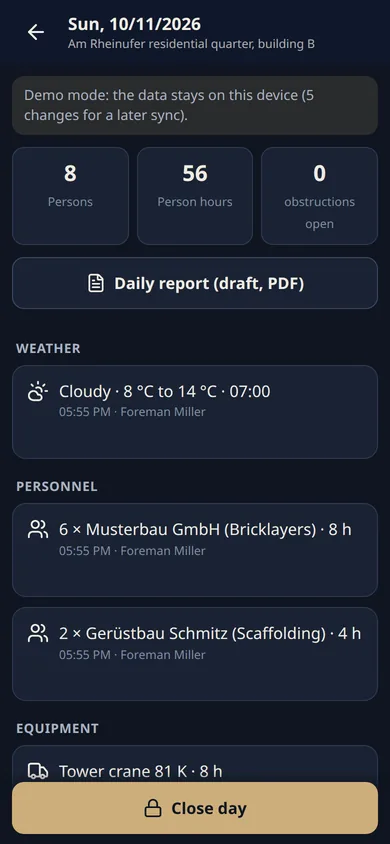

Site app: today's site diary with weather, staff and equipment
Construction site

The site diary in your pocket

The site foreman records weather, staff, equipment, work performed and deliveries in the site app – with photos and even without a network connection. Obstructions are documented immediately and visible in the office.

  • Works offline, syncs when a connection is available
  • Daily report as PDF for the client
Invoicing

Take-off and progress invoice in one go

Enter take-off sheets manually or import them as GAEB X31. As soon as a sheet has been verified, it counts towards the next progress invoice – progress payments already invoiced are deducted automatically.

  • Verification status per take-off sheet, invoiced sheets locked
  • Invoice as PDF with embedded XRechnung
Take-off · Haus BLive application

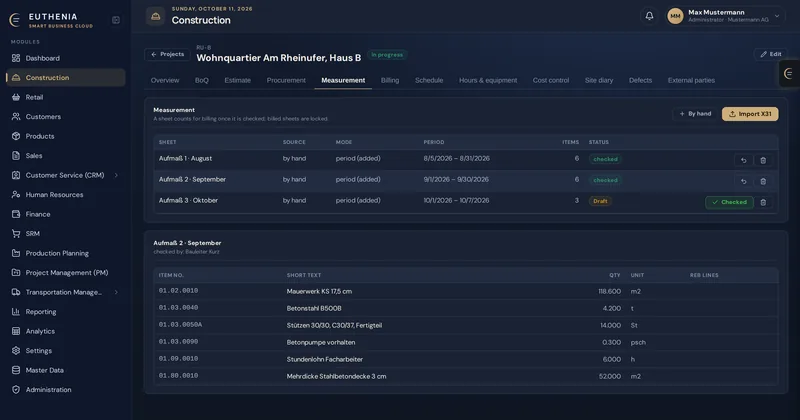

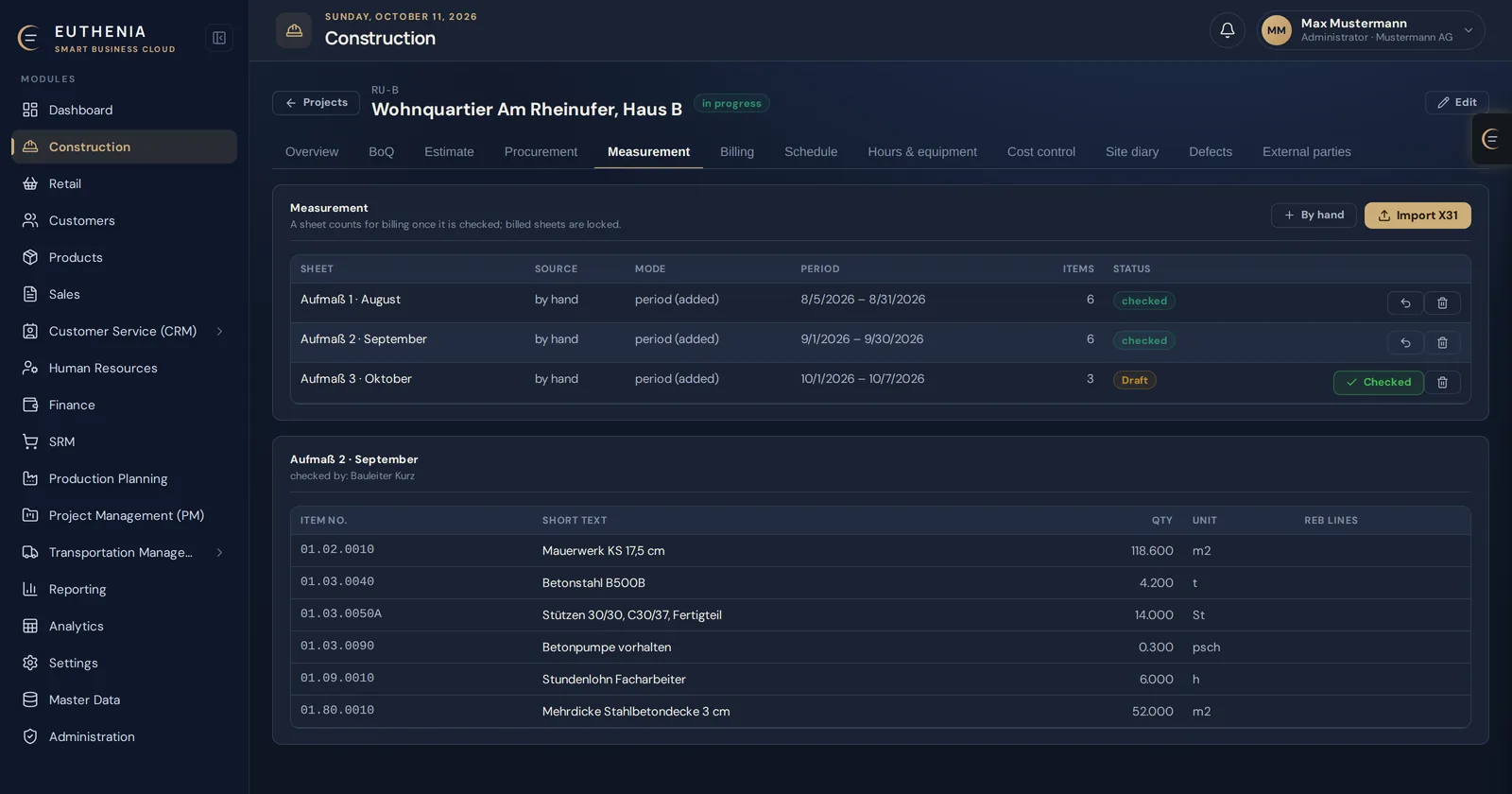

Take-off sheets from August to October with verification status and quantities per BoQ item
Defects · Floor plan 1st floorLive application

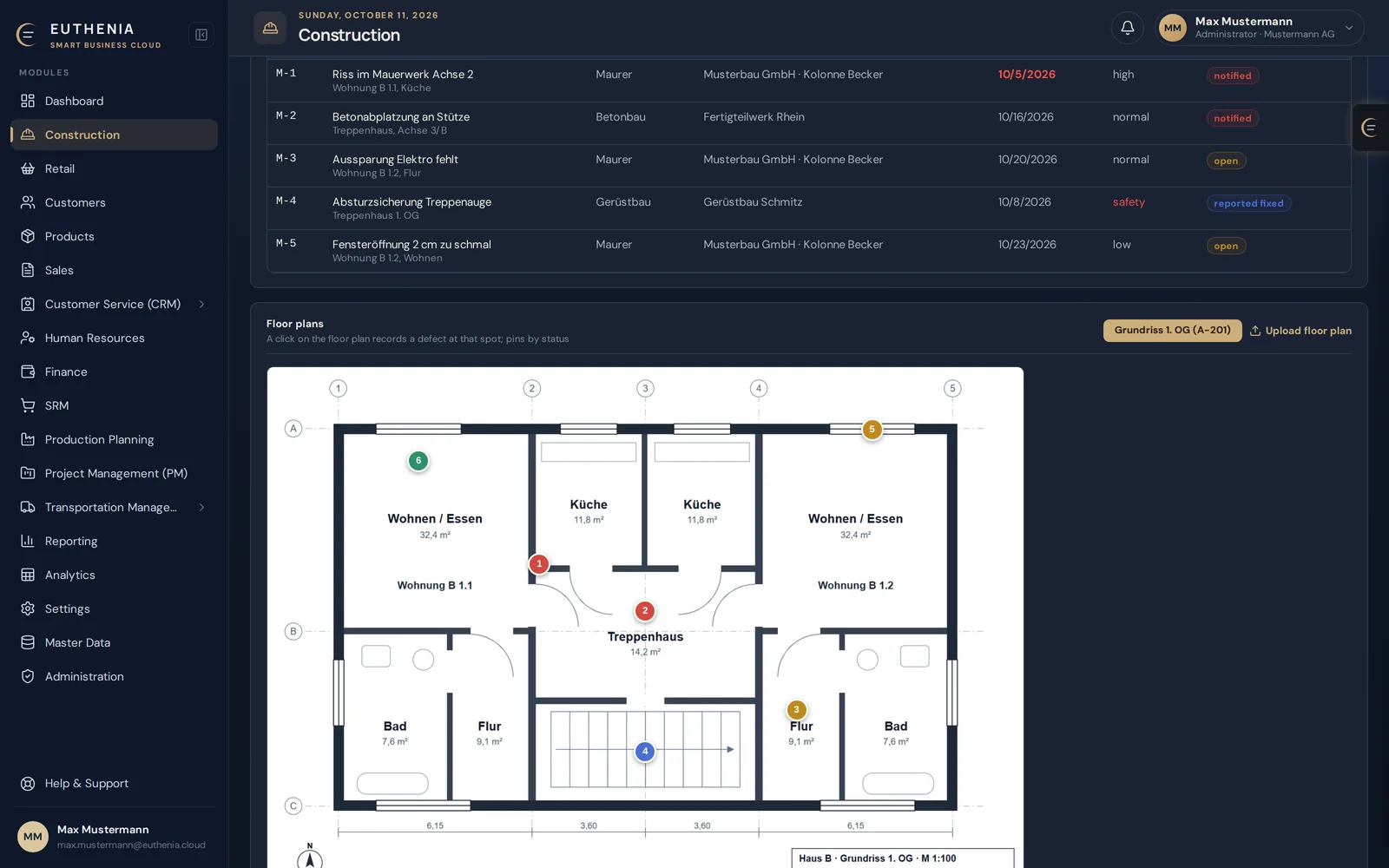

Defect list with trade, deadline and status, below it the floor plan with the defects shown as dots
Quality

Defects right where they are

One tap on the plan, a photo, deadline and trade – done, even without a network connection. Subcontractors mark defects as resolved through their personal access – with a photo – while site management keeps track in the office all the way to acceptance.

  • Status and deadlines per trade, overdue items in red
  • Photos and history for every defect
Controlling

Post-calculation while you build

Booked hours, equipment usage and invoices from suppliers and subcontractors flow into the project continuously. So you see deviations while you can still take corrective action.

  • Planned and actual per cost type and BoQ item
  • Early warning as soon as an item exceeds its target
  • Commitments from awarded subcontractor work included in the forecast
Post-calculation · Haus BLive application

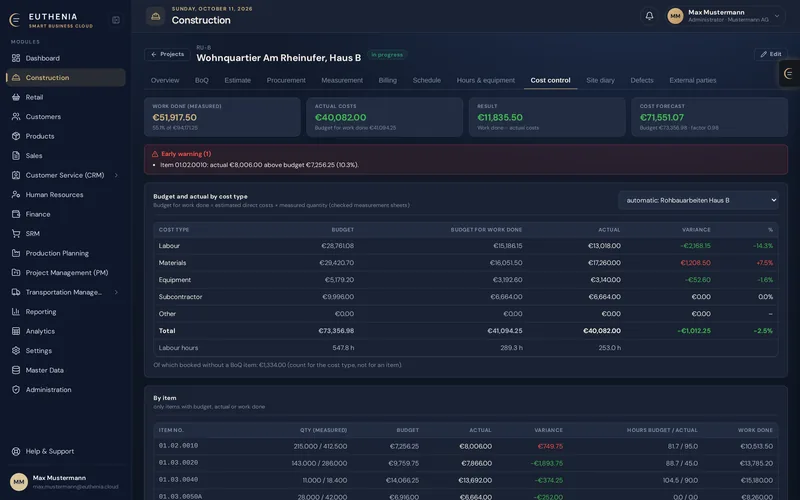

Post-calculation with work performed, actual costs, result and forecast, early warning and planned vs. actual per cost type

Pricing

Office and site – two prices

You only distinguish between office and site users; external parties are free. Includes EUTHENIA ERP Business in full. GAEB, measurement and VOB invoicing are included at no extra charge.

Office user

€79per user / month

monthly €92

Estimating, site management and invoicing: bills of quantities (GAEB), bid calculation, construction schedule, measurement, invoices according to VOB with XRechnung, subcontractor awarding, post-calculation.

Site user

€19per user / month

monthly €22

Construction site app for foremen and fitters: site diary with photos and defects on the plan – also offline.

External parties

€0unlimited

Subcontractors, clients and planners see plans, defects and the site diary, send photos and report defects as fixed.

Try it now

30 days free, no obligation

Register your company and try EUTHENIA Construction together with EUTHENIA ERP – no payment details required. Pilot companies that help us develop Construction further get the first year at half price.

Try free for 30 days

Already a customer? Sign in to EUTHENIA Construction – with your EUTHENIA account.

  1. 1
    Register

    Create your company – “Also try EUTHENIA Construction” is already ticked.

  2. 2
    Approval and 30-day trial

    After our review, you receive your access by email – with your own tenant, empty or with sample data.

  3. 3
    Keep using it

    We support you during the switch and import your bills of quantities.

The screenshots on this page show a sample project with fictitious data.
